Back to Portfolio

Project 01

Project Management

A structured project management framework that gave leadership visibility into ongoing work.

Category
Operations · Project Management
Duration
8 weeks
Deliverables
Framework, trackers, reporting cadence

Overview

As AssistIQ grew, multiple operational initiatives were running simultaneously, making it difficult to track progress, identify risks, and keep leadership informed. I developed a structured project management framework that introduced clear planning, consistent reporting, and greater visibility across the entire project lifecycle.

The Challenge

Projects were being managed independently with no standardized approach to planning or reporting. This made it difficult to monitor progress, anticipate risks, and ensure work stayed aligned with business priorities.

My Approach

I designed a simple yet structured project management system that supported each stage of execution, from initial planning through completion. The framework established consistent documentation, regular progress reporting, risk tracking, and operational visibility, enabling leadership to make informed decisions throughout the project lifecycle.

Deliverables

What was built.

The project management framework consisted of six key operational deliverables that supported each stage of the project lifecycle.

01

Project Brief

AssistIQ project brief document, first pages

AssistIQ project brief document, continued pages

Established the project's objectives, scope, stakeholders, timeline, and success criteria to align the team before execution began.

02

Project Timeline

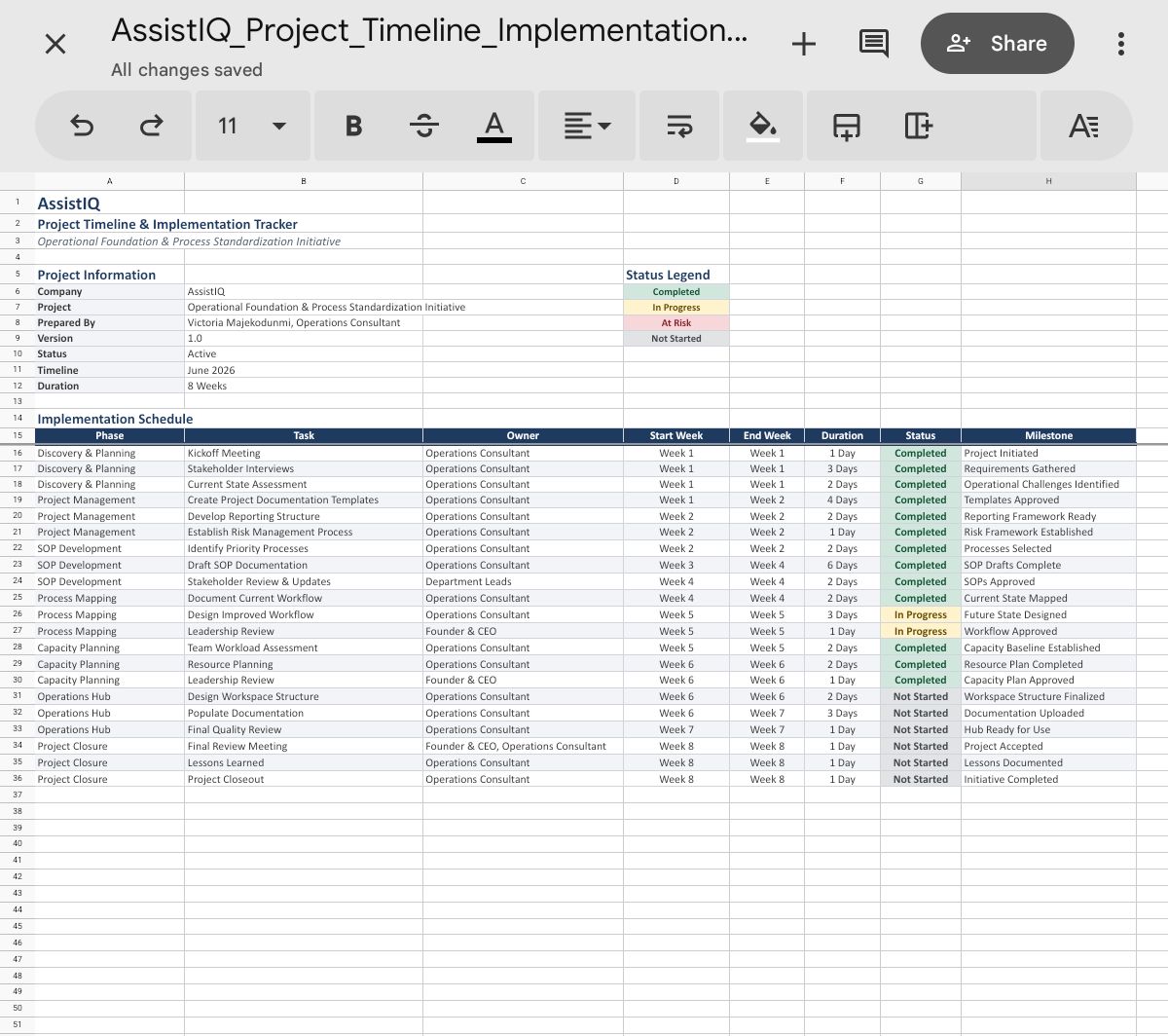

Project timeline showing phases, milestones and deadlines

Mapped out key phases, milestones, and deadlines to provide a clear roadmap for project execution.

03

Status Reports

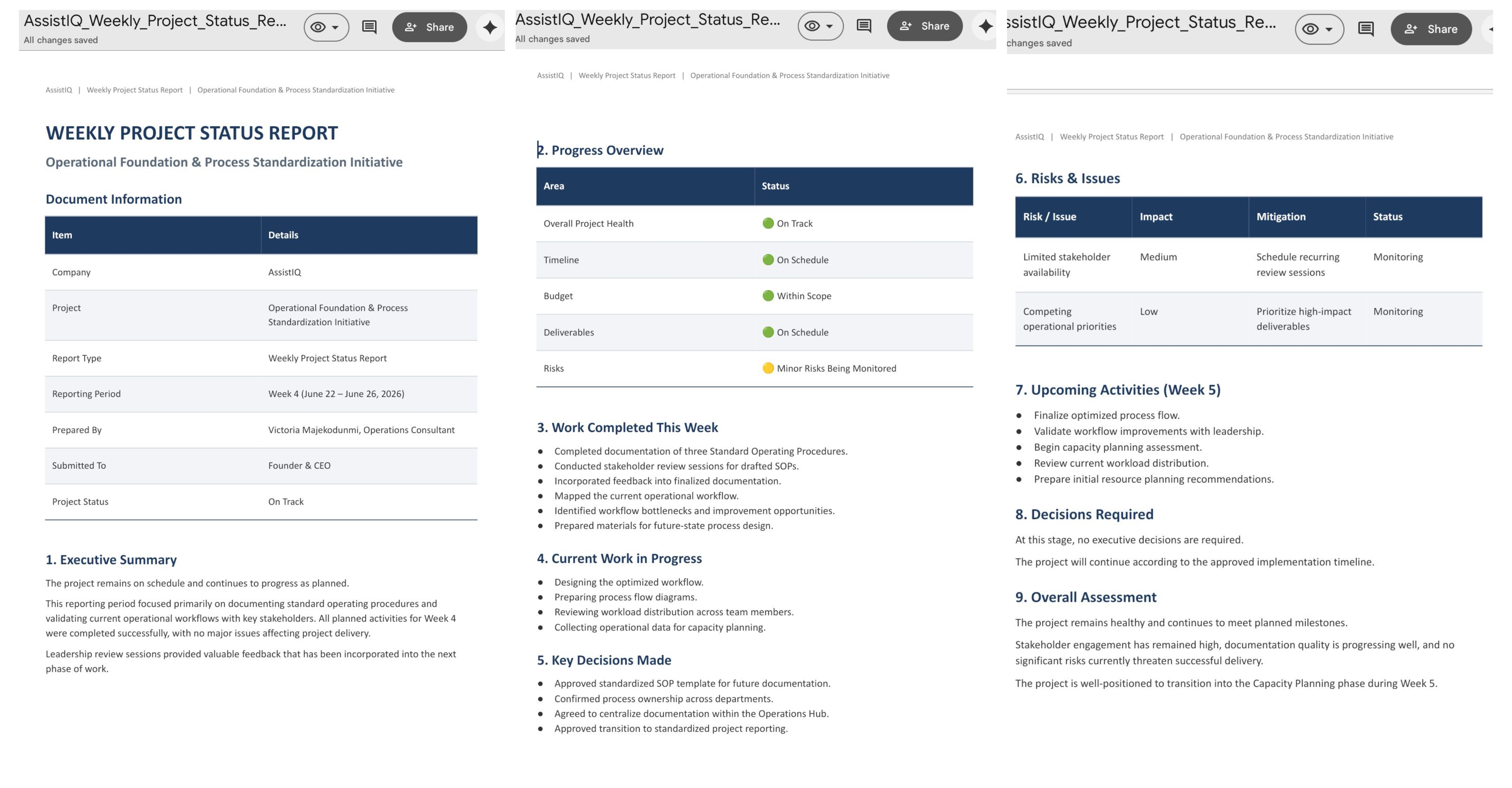

Weekly project status report

Provided regular progress updates, highlighted completed work, tracked upcoming priorities, and kept leadership informed throughout the project.

04

Risk Log

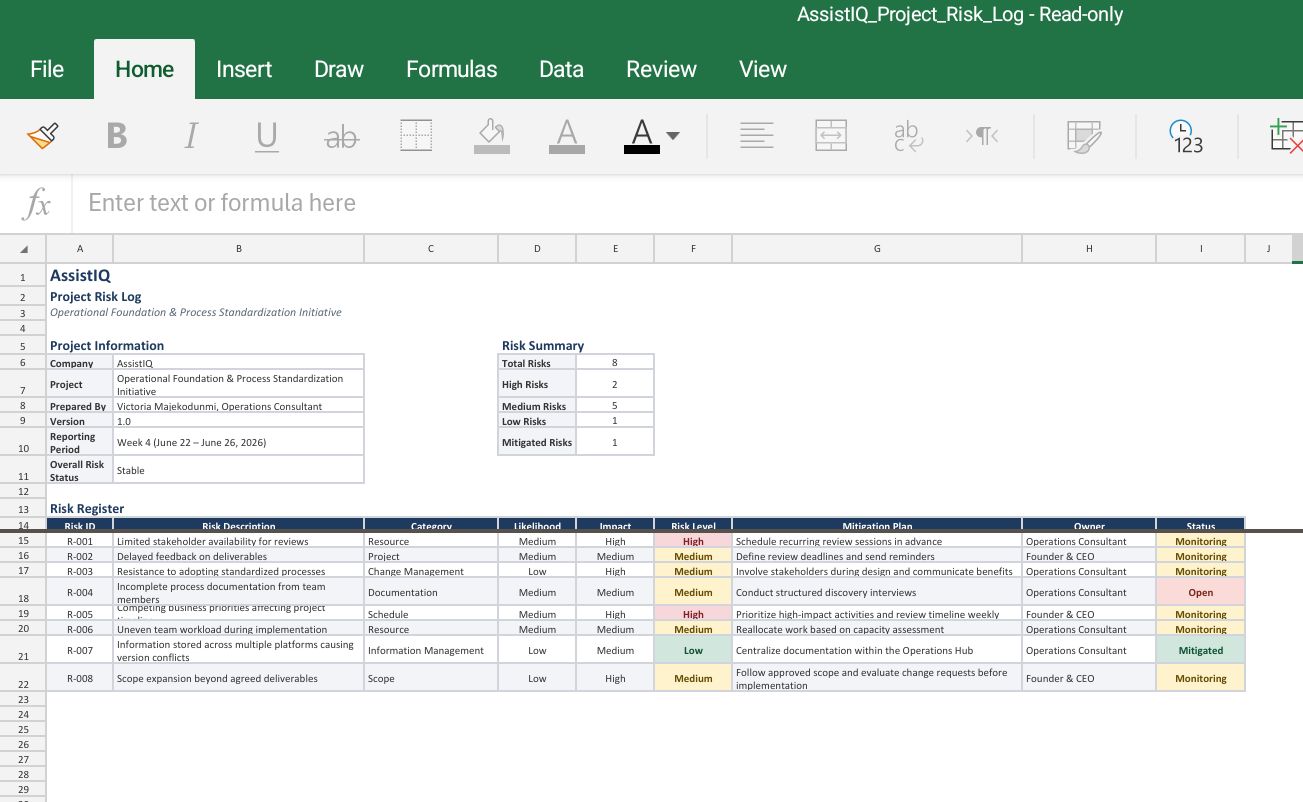

Project risk log with impact and mitigation plans

Recorded potential project risks, assessed their impact, and documented mitigation plans to support proactive decision-making.

05

Operations Dashboard

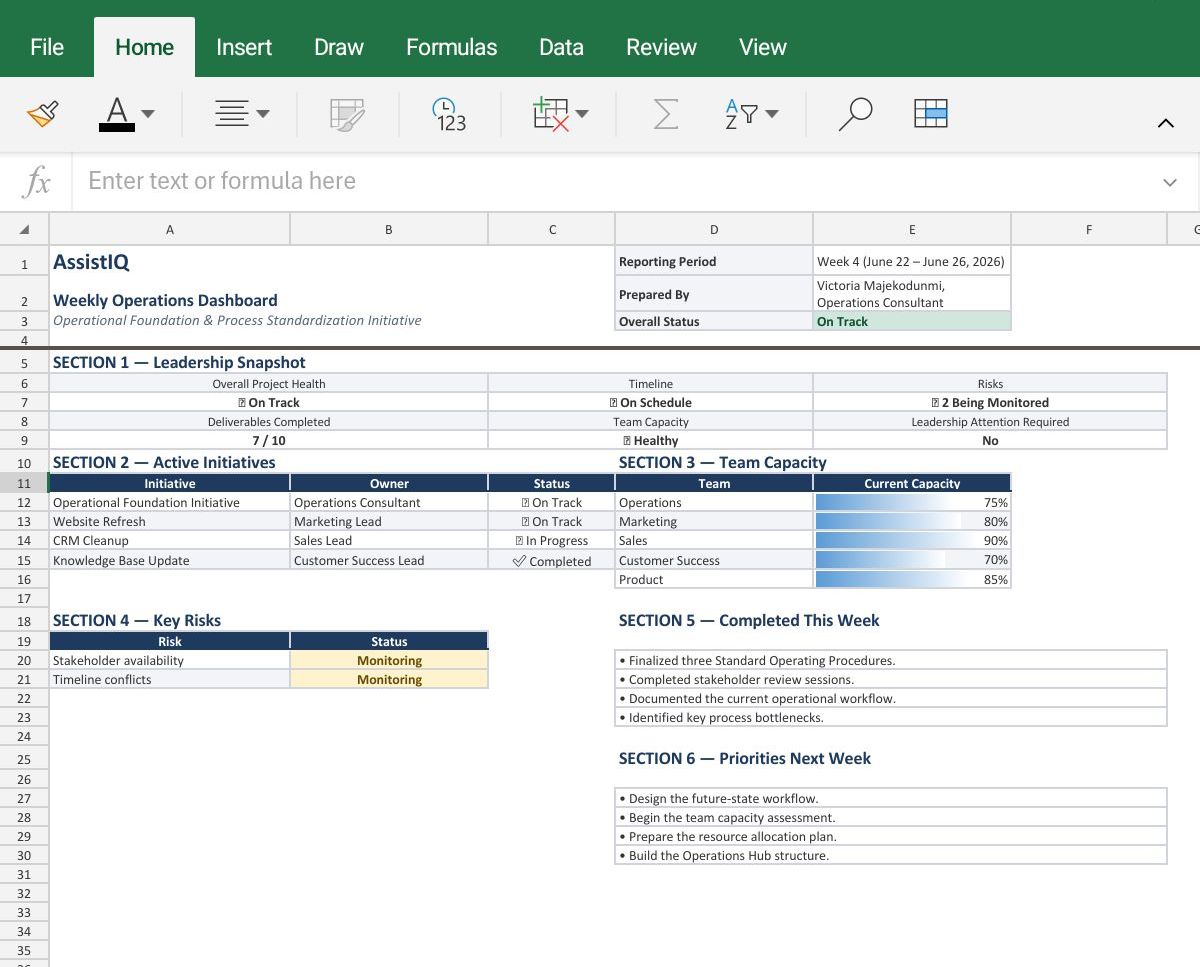

Operations dashboard with progress, capacity and risks

Presented a centralized view of project progress, team capacity, key risks, completed work, and upcoming priorities for quick operational visibility.

06

Project Closure Report

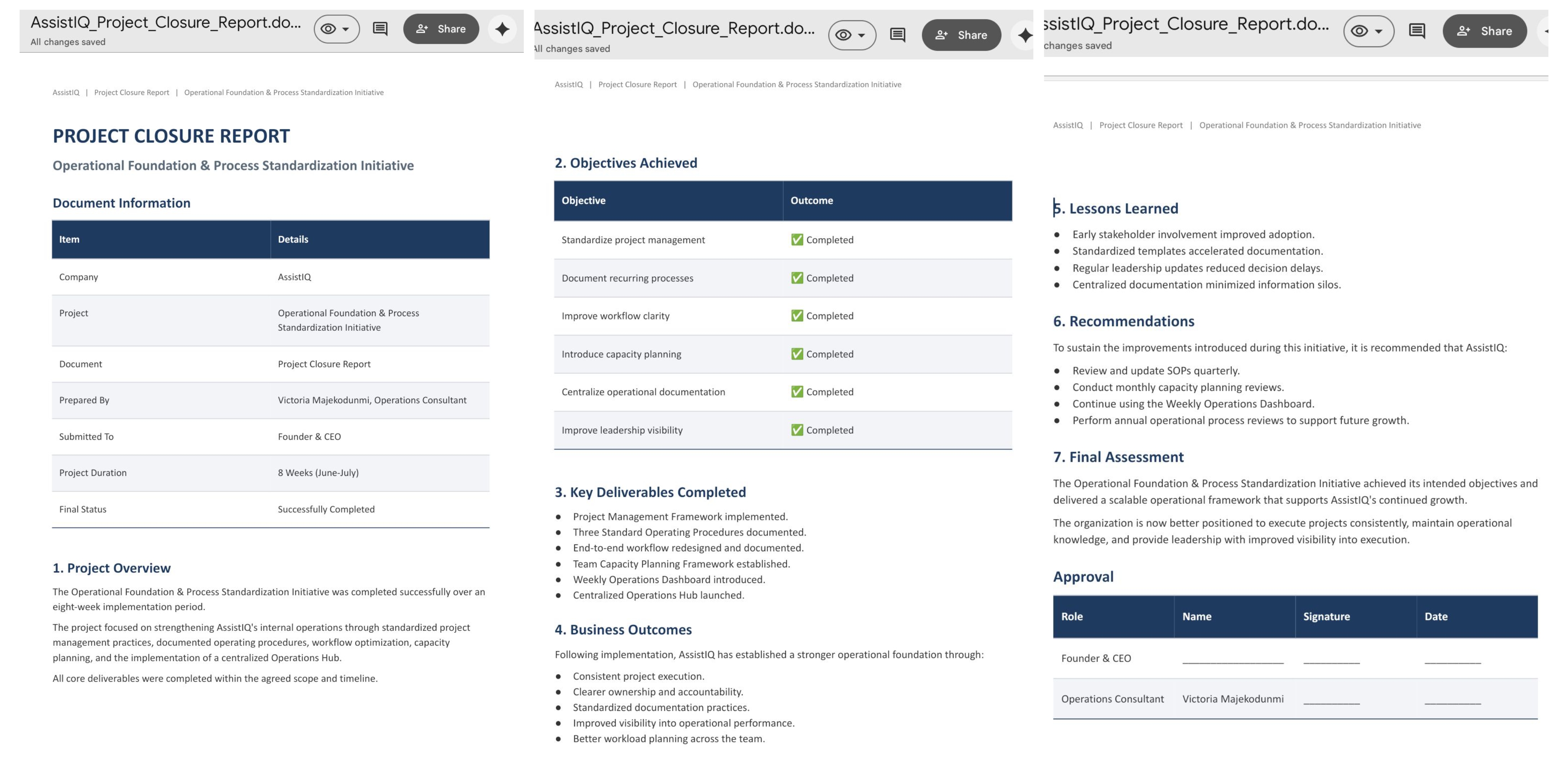

Project closure report with outcomes and lessons learned

Documented project outcomes, key achievements, lessons learned, and recommendations to support continuous improvement in future projects.

Outcome

The new framework created a more organized and transparent way to manage projects. Leadership gained clearer visibility into execution, risks were tracked proactively, progress became easier to communicate, and projects followed a consistent process from planning through completion.

Contact

Ready to build stronger operations?

If you're looking for someone who can bring structure to your operations, improve the way work flows, and build systems that support consistent execution, I'd love to learn more about your business and explore how I can help.
